Dynamics 365 Go-Live Checklist: What to Complete Before Deployment
A Dynamics 365 go-live checklist helps teams confirm that the solution, data, integrations, users, security, training, and support processes are ready before production deployment. It is not just a technical task list. It is a business readiness framework for deciding whether the organisation can safely move from project mode into daily operations.
Use this checklist to confirm the core areas that usually determine deployment readiness:
Dynamics 365 Go-Live Checklist
| Area | What to confirm |
|---|---|
| Scope | Business requirements and acceptance criteria are signed off. |
| Security | Users, teams, business units, and security roles are validated. |
| SIT | Integrations, workflows, data flows, and automation have been tested together. |
| UAT | Business users have completed acceptance testing with standard permissions. |
| Performance | Expected production loads and key transactions have been tested. |
| Data migration | Migration rehearsals, record counts, relationships, and reconciliations are complete. |
| Integrations | External systems, endpoints, monitoring, and fallback processes are confirmed. |
| Cutover | Tasks, owners, timings, decision points, and rollback steps are documented. |
| Training | Users, managers, super-users, and support teams understand the new process. |
| Hypercare | Post-launch triage, issue ownership, and operational handover are ready. |
For example, a national service organisation replacing disconnected customer databases may need finance, operations, and support teams to agree on exactly when a record is ready for migration. In that scenario, the checklist is not just a technical document. It becomes the shared reference for who approves data quality, who signs off security access, and who decides whether the business is ready to proceed.
Dynamics 365 deployment often involves operational change across customer management, reporting, process automation, and information access. Proper preparation can reduce disruption across core business activities, especially where CRM is connected to finance, field service, portals, reporting, or customer support workflows.
Frameworks like Microsoft Success by Design treat readiness as a connected set of verification steps. BeyondCRM applies that guidance in practical CRM design, implementation, customisation, training, and ongoing support work for complex business environments across Australia, the United States, and the Asia Pacific region.

I’m Warren Davies, Founder of BeyondCRM. In complex Dynamics 365 projects, I usually see deployment readiness work best when teams treat it as a business decision framework, not a last-minute technical task. The goal is to help leaders confirm that users, data, integrations, support processes, and go-live responsibilities are genuinely ready before the system becomes business-critical.
Before Go-Live: Environment Setup, Security, and User Readiness
Before go-live, the project team should confirm that the production environment is secure, stable, and aligned with the way people will use Dynamics 365 every day. This stage covers the technical baseline, but it can also protect the business from access problems, reporting errors, and workflow failures after launch.
Environment topology should separate sandbox, testing, and production instances within Microsoft Power Platform and Dataverse. Production tenants require clear administrator assignments, appropriate region selection, capacity planning, backup procedures, and controlled release management so background jobs or poorly timed changes do not affect daily operations.
Configure Tenant Prerequisites and Environment Security
Preparing the technical container means completing essential administrative, network, and governance tasks before broad user access begins. Administrators should protect recovery options, review environment settings, remove sample data, and standardise system behaviour where configuration choices affect users.
Network settings should support encrypted communication between client devices and server-side services. In hybrid scenarios requiring Internet-Facing Deployments, claims-based authentication using Active Directory Federation Services and OAuth protocols can support secure remote access where configured appropriately.
For additional administrative guidance, consult official Post-installation and configuration guidelines for Microsoft Dynamics 365 documentation.
Security deserves more than a final review. Teams should confirm role-based access, least-privilege design, business-unit visibility, field-level security, production access, and security sign-off before UAT starts. Testing with administrator permissions can hide the exact issues that may affect everyday users.
BeyondCRM insight: One common go-live mistake is allowing project teams to test too much of the system with elevated permissions. A workflow may appear to work perfectly for administrators while failing for the people who need to use it under real security roles.
In a practical rollout, this might mean creating separate roles for field staff, managers, finance users, and customer service teams before UAT begins. If everyone tests with administrator access, the project may miss field-level restrictions, approval routing issues, or business-unit visibility problems that only appear when real user profiles are applied.
Deploy and Manage Client Applications Securely
Client touchpoints such as Outlook integration, Teams collaboration, mobile access, and automated agents should be reviewed before launch day. Server-side synchronisation may handle automated communications between Exchange Online and Dynamics 365, including email capture, appointment tracking, and contact linking, depending on licensing and tenant configuration.
When extending capabilities to Copilot or automated agents, permissions must follow organisational security policies and be tested against real user profiles:
- Assign role-based access controls using least-privilege principles rather than administrative rights.
- Verify that staff only view records matching their business permissions.
- Restrict guest access accounts in Microsoft Entra ID where cross-tenant policies apply.
- Allow time for tenant-wide app deployments to propagate across interfaces before training.
- Confirm that users can access the correct apps, views, dashboards, and records without unnecessary privileges.
Prepare Users, Training, and Communications
A Dynamics 365 implementation checklist should include user readiness, not only system readiness. Training needs to explain what changes, why it matters, who owns each process, and where users should go for help after go-live.
Before launch, confirm that super-users are nominated, training sessions are complete, user guides reflect the final configuration, and business communications explain the cutover timeline. Managers should also understand what will be different on day one, especially if approvals, reporting, customer handovers, or service workflows change.
Before Go-Live: Testing, UAT, Performance, and Data Migration
Testing validates whether Dynamics 365 is ready to support business activity in production. A strong Dynamics 365 deployment checklist should separate technical testing from business acceptance so defects are more likely to be found at the right stage and fixed by the right team.

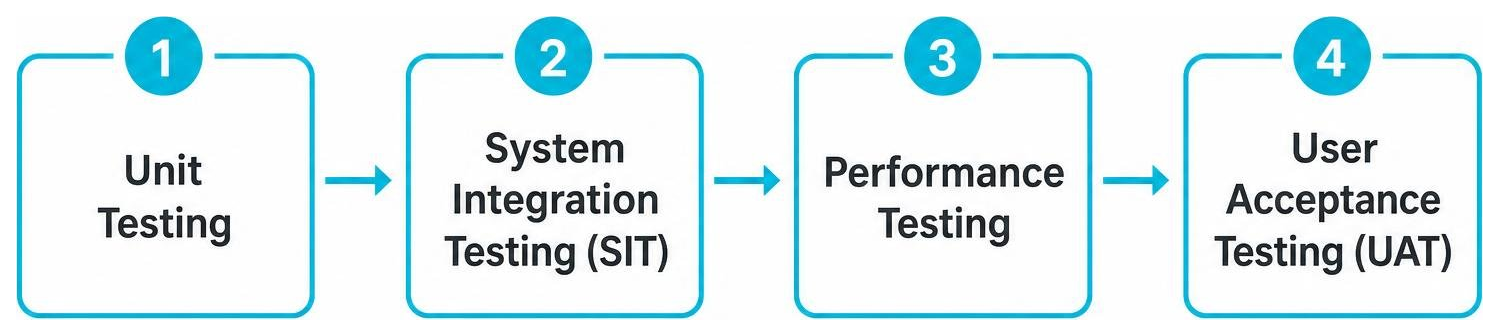

Quality assurance usually moves through unit testing, System Integration Testing, regression testing, performance testing, and User Acceptance Testing. Each stage lowers a different type of risk.

System Integration Testing should precede UAT. This phase verifies that automated data pipelines, custom APIs, middleware, workflows, finance systems, ERP platforms, portals, and external connectors transfer data correctly and handle errors appropriately.
Performance testing evaluates platform responsiveness under expected loads. Test scripts should simulate common transactions, concurrent searches, background workflows, reporting activity, and peak usage patterns to identify bottlenecks before go-live.
For example, a customer support team may believe its case escalation workflow is ready because records move correctly inside Dynamics 365. SIT may reveal that the same escalation fails when an external portal submits incomplete customer details or when an ERP update arrives out of sequence. Finding that issue before UAT can prevent business testers from spending time on defects that belong to the integration layer.
Execute User Acceptance Testing with Operational Roles
User Acceptance Testing checks whether the configured CRM design supports daily operational workflows. It should be run by business users with standard security roles, not by administrators testing ideal paths.
Admin accounts can bypass field security restrictions and business-unit hierarchies, hiding potential access errors that could block standard users.
A useful UAT scenario might ask a department manager to create a new account, assign a follow-up task, approve a discount request, and check whether the reporting dashboard updates correctly. That type of role-based test shows whether the configured process supports daily work, not just whether individual screens load.
To run effective UAT cycles:
- Document explicit pass and fail criteria mapped to requirements.
- Load realistic, anonymised sample records reflecting actual data complexity.
- Engage departmental super-users who understand daily operational workflows.
- Test approvals, handovers, dashboards, notifications, and exception paths.
- Log, prioritise, and re-test defect fixes within a structured management workflow before final sign-off.

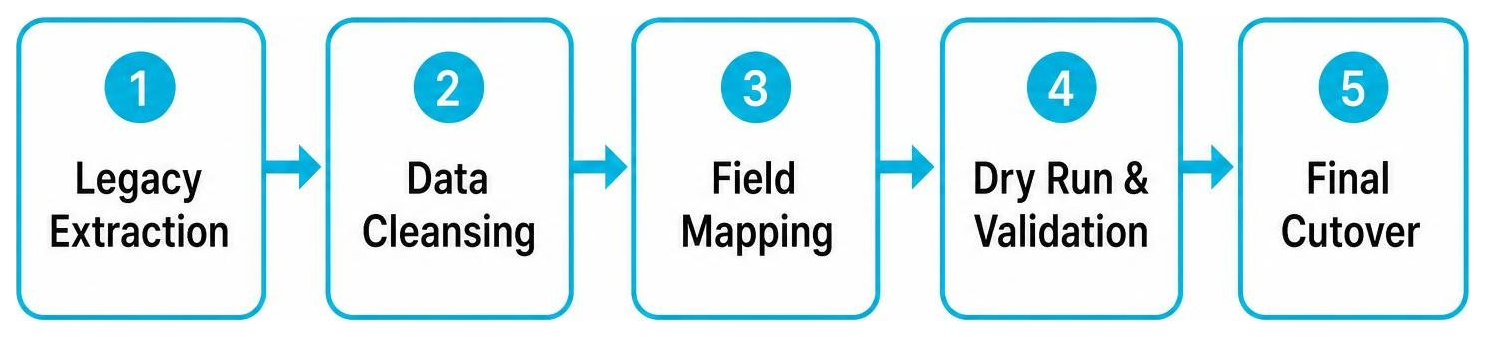

Prepare Data Migration Readiness
Data migration requires a structured pipeline covering extraction, cleansing, transformation, deduplication, relationship mapping, historical data decisions, and loading. Planning helps prevent incomplete or inconsistent legacy records from reducing reporting accuracy after launch.

Running multiple migration dry runs helps technical teams measure execution timing accurately. Rehearsals determine the likely window required for final production cutover and reveal whether the business can reconcile the migrated information with confidence.
A common project example is a business merging several legacy contact lists where customer names, account ownership, email formats, historical activities, and duplicate records are inconsistent. A dry run gives the team time to agree on matching rules and exception handling before those records influence live service, sales, or reporting decisions.
Key steps for migration readiness include:
- Cleansing and deduplicating legacy contact and account data before final export.
- Mapping legacy schema fields accurately to Dataverse tables and custom attributes.
- Preserving required relationships between accounts, contacts, opportunities, activities, cases, and custom records.
- Deciding how much historical data should be migrated, archived, or made available through reporting.
- Executing migration scripts repeatedly in a staging environment that reflects production capacity.
- Validating record counts, balances, lookup links, ownership, field formatting, and exception reports after every rehearsal.
- Confirming the timing and scope of the final delta migration.
- Securing formal data sign-off from business leaders before starting live cutover.
During Cutover: Deployment, External Dependencies, and Go/No-Go Decisions
During cutover, the project team moves from preparation to controlled execution. This is where the Dynamics 365 implementation checklist becomes a timed operational plan covering system freeze, final migration, configuration deployment, smoke testing, go/no-go approval, and user access.
Develop a Technical Cutover Checklist for Dynamics 365
A technical cutover checklist establishes the sequence for configuration imports, data loads, environment checks, user access, and communication. It defines decision criteria and rollback steps if technical blockers occur.
Essential technical cutover components include:
- Setting legacy databases to read-only status to prevent new record entry during transition.
- Exporting managed solutions from staging environments and importing them into production.
- Completing post-installation tasks, including security role assignments and team setup.
- Executing final delta data migration scripts to transfer newly created legacy records.
- Performing smoke testing across core entities, forms, views, dashboards, and workflows.
- Confirming that integrations, email, reporting, and user access work in production.
- Holding scheduled evaluation meetings with project leaders before granting broader access.
- Maintaining rollback procedures detailing restore steps, communication actions, and decision authority if unresolvable issues arise.
Microsoft provides structured go-live checklist guidance within the Success by Design framework to help organisations review launch criteria.
A practical cutover example is a service organisation that needs customer support, finance, and field operations to stop using legacy systems at different times. The technical plan may look simple on paper, but the real consulting value is in sequencing those freezes so teams are less likely to lose transactions, duplicate updates, or miss urgent customer cases during the transition.
Confirm External Systems and Integration Readiness
Dynamics 365 environments often connect to accounting systems, ERP platforms, customer portals, marketing platforms, email services, reporting tools, middleware, and operational databases. Each dependency needs a production-readiness check.
Confirming integration readiness requires coordinating with software vendors and internal IT owners. API keys, secrets, certificates, endpoints, tenant permissions, retry rules, monitoring alerts, and scheduled jobs should match production configurations rather than sandbox environments.
Test system behaviour when external dependencies fail. Simulating API downtime during integration testing verifies that Dynamics 365 logs errors clearly, retries transaction queues where configured appropriately, and gives support teams enough information to investigate problems without losing business-critical records.
BeyondCRM insight: Integration testing should include imperfect conditions. Real deployments rarely fail because the happy path was not tested. They often fail because no one checked what happens when a finance system is unavailable, a portal sends incomplete data, or middleware processes records in a different order than expected.
How to Know If Dynamics 365 Is Ready for Go-Live
A Dynamics 365 system is ready for go-live when business, technical, data, security, and support owners can jointly approve the risk of moving into production. The decision should be explicit rather than assumed.
Use these go/no-go criteria before launch:
- All critical defects are resolved or formally accepted with an owner and workaround.
- UAT is signed off by the right business stakeholders.
- Performance testing has covered expected usage patterns.
- Data migration results are reconciled and approved.
- Security roles have been tested with real user profiles.
- Integrations have been validated in production-like conditions.
- Cutover activities have been rehearsed and assigned to named owners.
- Rollback steps are documented and understood.
- User training, communications, and super-user support are complete.
- Hypercare resources, ticket triage, and escalation paths are confirmed.
- Business stakeholders have approved the final go/no-go decision.
If one of these points is unresolved, the project may still proceed, but the risk should be visible and accepted by the right decision-makers. That clarity is often more useful than pretending every issue has disappeared.
After Go-Live: Hypercare, Monitoring, Handover, and Common Mistakes
After go-live, the priority shifts from deployment execution to stabilisation. Hypercare provides dedicated technical support and active monitoring so user issues, integration errors, security gaps, and process confusion can be resolved before they become embedded operational problems.

Hypercare often runs for two to six weeks depending on solution scale, user volume, data complexity, integration risk, and business change readiness. Technical specialists work alongside internal support teams to triage tickets, monitor workflows, review system performance, and refine processes where appropriate.
A practical after-go-live framework should cover:
- Daily issue triage with clear severity levels and owners.
- Monitoring of integrations, background jobs, workflows, and performance.
- Super-user support for common user questions.
- Review of reporting, dashboards, and operational handover points.
- Regular communication to managers and stakeholders.
- A transition plan from project support to normal operational support.
Establishing internal super-users can strengthen long-term adoption. Training department leads creates accessible peer support, may reduce standard helpdesk ticket volumes, and encourages consistent tool usage.
For example, a large operations team may find after launch that users are entering customer notes inconsistently, even though the system is technically stable. A well-run hypercare period gives consultants and internal super-users a clear forum to identify whether the issue is training, form design, security permissions, or a process rule that needs refinement.
Project teams can manage deployment communications and FastTrack reviews through official portals to help delivery teams and consulting partners remain aligned.
Common Dynamics 365 Go-Live Mistakes
Many go-live problems come from weak readiness decisions rather than the platform itself. Watch for these common mistakes:
- Testing with administrator permissions: This can hide security, visibility, and approval-routing issues that affect standard users.
- Treating UAT as a technical test: UAT should confirm whether business users can complete real work, not simply whether screens load.
- Skipping migration rehearsals: Without dry runs, teams may underestimate timing, data quality issues, or reconciliation effort.
- Testing integrations only when everything works: Failure handling, monitoring, and retry behaviour need to be tested too.
- Leaving security configuration until the end: Late security changes can affect workflows, reporting, and user acceptance.
- Failing to define go/no-go criteria: Without clear criteria, launch decisions become subjective and rushed.
- Not rehearsing cutover: A cutover plan should be timed, assigned, and tested before the live weekend or launch window.
- Underestimating user training: Users need to understand new processes, not just new screens.
- Ending support too quickly after launch: Hypercare should run long enough for recurring issues and adoption problems to appear.
- Having no clear rollback plan: Even if rollback is unlikely, the business should understand what would trigger it and who can approve it.
BeyondCRM insight: A good Dynamics 365 go-live checklist cannot remove every issue. It makes the remaining risks visible, owned, and manageable before the business relies on the system.
Frequently Asked Questions About a Dynamics 365 Go-Live Checklist
These questions address common search intents around Dynamics 365 deployment readiness, cutover planning, testing, data migration, and post-launch support.
What is a Dynamics 365 go-live checklist?
A Dynamics 365 go-live checklist is a structured readiness document that helps teams confirm whether the solution, data, integrations, users, security, training, cutover plan, and support model are prepared for production use. It supports the final decision about whether the business is ready to move from implementation into live operations.
What should be tested before Dynamics 365 goes live?
Before Dynamics 365 goes live, teams should test core business processes, security roles, integrations, workflows, approvals, dashboards, reports, data migration results, performance, email synchronisation, and exception handling. UAT should be completed by business users with realistic records and standard permissions.
How long does a Dynamics 365 go-live take?
The go-live window depends on the complexity of the solution, the volume of data, integration dependencies, user count, and cutover approach. Some launches may complete over a short planned window, while larger enterprise or government environments may require staged deployment, phased user access, and extended hypercare.
What should be included in a Dynamics 365 cutover plan?
A Dynamics 365 cutover plan should include system freeze timing, final data migration, solution deployment, smoke testing, integration checks, user access, communication steps, go/no-go decision points, named owners, escalation paths, and rollback procedures.
What happens during Dynamics 365 hypercare?
During hypercare, project and support teams monitor the live system, triage user issues, check integrations and background jobs, support super-users, refine urgent process problems, and prepare the handover to normal operations. Hypercare gives the business a focused support period immediately after launch.
What causes a Dynamics 365 go-live to be delayed?
A go-live may be delayed by unresolved critical defects, incomplete UAT, poor data migration results, untested integrations, unclear security roles, weak performance, missing user training, lack of stakeholder sign-off, or an incomplete cutover and rollback plan.
Who should approve a Dynamics 365 go-live?
Go-live approval should usually involve business owners, project sponsors, solution leads, data owners, security or compliance representatives, operational managers, and technical delivery leads. The exact group depends on governance requirements, business risk, and the scope of the Dynamics 365 implementation.
What data should be checked before Dynamics 365 migration?
Before migration, teams should check record counts, duplicates, required fields, ownership, relationships, historical data requirements, formatting, lookup values, inactive records, security-sensitive fields, and reconciliation reports. Business data owners should approve the results before final cutover.
Finalising Your Dynamics 365 Go-Live Checklist
A successful Dynamics 365 rollout requires more than completing technical tasks. The strongest deployment decisions bring together scope, security, testing, data migration, integrations, cutover planning, user readiness, and post-launch support in one clear readiness framework.
A practical Dynamics 365 go-live checklist helps leaders answer the most important question before launch: are the business, users, data, integrations, and support teams ready to rely on the system every day?
BeyondCRM provides specialised Microsoft Dynamics 365 CRM design, implementation, customisation, automation, user adoption, training, and ongoing support for large enterprises, government organisations, and complex business environments. To structure your rollout or review an existing go-live plan, explore these relevant services:
- Dynamics 365 CRM Support Services
- Microsoft Dynamics 365 CRM Implementation
- CRM Data Migration Services
The educational takeaway is simple: treat go-live as a controlled readiness decision, not a date on a project plan. A checklist works best when every unresolved risk has an owner, a decision path, and a practical support plan.
